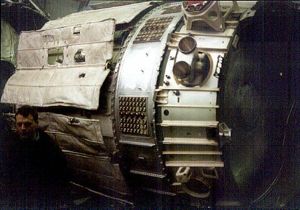

LOK Cutaway Credit: © Mark Wade |
AKA: 11F93;7K-LOK;LOK;LOK, T1K;T1K. Status: Operational 1971. First Launch: 1971-06-26. Last Launch: 1972-11-23. Number: 2 . Thrust: 33.22 kN (7,469 lbf). Gross mass: 9,850 kg (21,710 lb). Unfuelled mass: 6,698 kg (14,766 lb). Specific impulse: 314 s. Height: 10.06 m (33.00 ft).
Given its importance to the Soviet moon landing program, it remains one of the least known manned spacecraft ever to reach flight status. Never reaching space in its all-up form, the LOK was the counterpart to the American CSM (Command-Service Module).
The LOK was radically different from other spacecraft in the Soyuz series in many respects. The BO orbital module differed from the basic Soyuz in having the Kontakt lightweight docking system, a forward reaction control system module, and a cupola allowing the cosmonaut to make a manual visual docking with the LK lunar lander. The descent module was true to the basic Soyuz form, but significantly heavier than either the 7K-OK earth orbit or 7K-L1 circumlunar versions of the module. The PO/AO service module was radically different from others in the Soyuz series. It featured the Block I propulsion system with a much more powerful engine and greater fuel capacity (required for the maneuver out of lunar orbit). Power was provided by Lox/LH2 fuel cells, a first for a Soviet spacecraft.
Development History - from L-4 to LOK
The first outline specification for a manned lunar orbiter came in a Korolev letter to the Central Committee of the Communist Part in January 1960. The Chief Designer proposed an aggressive program for Communist conquest of space. This would be accomplished by development of a new N1 rocket of 1,000 to 2,000 metric tons gross lift-off mass with a 60 to 80 metric ton payload at the earliest possible date. Among the potential payloads for his rocket in the period 1963 to 1965 Korolev proposed a spacecraft with 2 to 3 men for flyby of the moon, entry into lunar orbit, and return to earth. Payload mass would be 10 to 12 metric tons in lunar orbit with 2 to 3 metric tons return payload. This lunar orbiter would be twice as large as the L1 'loop around the moon' spacecraft. Following negotiations with other Chief Designers and the government, the final decree 715-296 of 23 June 1960 authorized draft project work on the L1 and the N1 booster but did not mention any N1-launched lunar orbiter.
Following three years of design and research, a series of potential lunar spacecraft designs were described in a 23 September 1963 letter setting out Korolev's space exploration plan for 1965 to 1975. One of these, the L-4 Manned Lunar Orbiter Research Spacecraft would have taken two to three cosmonauts into lunar orbit for an extended survey and mapping mission. The L-4 complex, with a total mass of 75 tonnes, would be placed into orbit in a single N1 launch, and would consist of:
At the time of this proposal Korolev favored an earth-orbit rendezvous method to reach the moon. This would require several N1 launches to assemble a 200 tonne spacecraft in low earth orbit. This would be launched directly to the lunar surface.
In August 1964 the Soviet Union finally decided to attempt to land a man on the moon before the United States. Korolev took the decision to use the American lunar orbit rendezvous method to reduce the number of N1 launches from three to one. The design work already accomplished on the L4 came in handy to provide a counterpart to the American Apollo CSM. Unlike the CSM, the Soviet LK lunar lander and LOK lunar orbiter would be braked into lunar orbit by a separate stage, the Block D. Therefore the propulsion system of the LOK would be needed only for the critical maneuver of propelling the spacecraft on the return trip for lunar orbit toward the earth. The LOK would have a smaller Block I propulsion stage than that planned for the L4:
Technical description of the LOK
The design mission of the LOK was house the mission crew and provide a means of escape during the trip to lunar orbit, to rendezvous and dock with the LK after its return from the lunar surface, and then return the cosmonauts and their lunar samples to earth. On precursor manned and unmanned missions the LOK would be equipped with photographic equipment to survey potential lunar landing sites. The LOK had an overall length of 10.0 m, a diameter of 2.2 m, and a total mass of 9,850 kg. It was designed to support two cosmonauts on lunar orbital missions of up to 13 days duration.
The LOK consisted of the following modules, from fore to aft:
In coming up into the BO from the SA, the cosmonaut first went through a short tunnel leading to the 'floor' of the BO. A cosmonaut floating above the tunnel and facing the hatch would find:
In preparation for the departure of the LK cosmonaut for the lunar surface, both crewmen would be present in the depressurized BO. The LK cosmonaut would be wearing a Krechet-94 space suit, and the LOK pilot the lighter Orlan suit. After exiting the BO the LK cosmonaut would move to a large telescoping boom mounted on the exterior of the module. This would take him back to the hatch in the outside of the LK shroud.
The use of a fuel cell was unique in the history of the Soviet space program and did not emerge again until the Buran shuttle orbiter of twenty years later. The Volna-20 fuel cells were developed by the Ural Electrochemical Enterprise. Each cells had a mass of 70 kg and could provide 1.5 kW of power at 27 V for 500 hours. The cells were fed by 600 kg of liquid hydrogen and oxygen. The water generated by the reaction of the hydrogen and oxygen was used by the crew.
Development and Flight History
Korolev had come up with using the lunar orbit rendezvous method for a lunar landing in response to the Soviet leadership demanding that he beat the Americans to the moon. Unfortunately, the leadership made this decision three years after the beginning of the Apollo project, and at the same time would not budget for more than four N1 launches a year. The only conceivable way of beating the Americans was to use a single N1 launch. But the N1 was designed to launch only 75 tonnes into low earth orbit, and OKB-1 calculations showed a minimum of 100 tonnes would be required for an LOR mission using Lox/Kerosene propellants in the booster.
Korolev was able to convince himself that by using a combination of modifications to the N1, chilled propellants, and modified trajectories he might be able to squeeze a 95 tonne payload out of the booster. This then had to be the total mass of the L3 assembly, including the trans-earth injection stage. This was the plan sold to the leadership, but as soon as development started it was apparent that a 95 tonne L3 would be unachievable.
The motivations for continuing were many. Mishin, Deputy Designer at OKB-1, wanted to go ahead with development of the N1 whether it could send a man to the moon or not. He believed it was critical to a range of future Soviet space projects and he was not about to kill it by telling the leadership it could not accomplish its only assigned mission. Bushuev noted the only way to get the necessary performance would be to use Lox/LH2 propellants in the second and third stages, as the Americans had done with the Saturn V. But this was not authorized in the approved draft project. Korolev was not about to tell the leadership that he had mis-estimated in their original proposal, or that Russian engines were not as good as American engines.
Two days after the N1-L3 one-shot scheme had been approved, a council of Chief Designers met to consider how to accomplish it. The use of Lox/LH2 stages was proposed to boost payload, but rejected due to the lack of Soviet experience with the propellants. The use of higher-performance N2O4/UDMH engines from Glushko was proposed, but again rejected by OKB-1. The designers became prisoners of their positions. There was no choice but to proceed with 95 tonne L3 as proposed. But this meant that the spacecraft estimated masses had no reserves. The LK mass was absurdly optimistic. During development the engineers would fight over grams of mass for subsystems.
The weight restrictions had consequences. By 20 December 1965 difficulties and arguments over development of the guidance system had reached a head. Pilyugin, the guidance subcontractor, wanted to use the latest technology in order to meet the weight and power consumption goals, including a digital computer and a gyroplatform of his own design. This was contrary to the decree, which required him to use a gyro platform from the customary supplier of OKB-1, Kuznetsov at NII-944. Pilyugin was reporting that he wouldn't have a guidance system ready for the N1 booster until late1968, let alone systems for the LOK and LK. Therefore an expert commission was convened by Keldysh, Head of the Soviet Academy of Sciences.
Korolev kicked off the meeting by complaining that if he had another 800 kg in payload mass, existing systems could be used. Pilyugin and Ryazanskiy provided an overview of their guidance systems, showing the concepts and the mass problems. The first launches could be made with the analogue systems desired by OKB-1, but the digital system would be required to conserve fuel cell consumables and accomplish a lunar landing mission. A discussion of fuel cell contractors led to a suggestion to use radio-isotope thermal generators (RTG's) from the KB Atomic Machinery Factory in the Urals. They had worked with Korolev for years on development of nuclear electric propulsion. But it was decided that there was no technical basis for proving reliable operation of RTG's in a vacuum. In addition, the fuel cells produced water for the crew, which would have to be carried separately if RTG's were used.
A month later Korolev was dead, and OKB-1 was without a Chief Designer. The leadership argued over the subject all during 1966. In the meantime, the American Apollo program was progressing rapidly, while the L3 project languished. It had become clear that a Soviet lunar landing could not be accomplished earlier than 1970, while the Americans were hoping for a landing in 1968 if all went well. By October 1966 the launch plan had slipped to the following:
It was also becoming apparent that the weight optimists were fighting a losing battle and that the N1 simply could not accomplish the one-launch scenario. This led to an examination of alternate launch plans. Meanwhile, amid a great deal of finger-pointing in the leadership, the decision was finally taken to appoint Mishin head of what was now dubbed TsKBEM in December 1966. The program lurched forward with the actual scenario for a lunar landing in constant flux.
Hardware development experienced continued delays. By the end of 1966 the Block I propulsion system was scheduled for its first ground tests in July 1967. New communications systems (Foton and Mezon) required to handle multiple manned spacecraft were not to be installed at ground stations until the end of the year.
Bushuev came up with plan in 1967 that provided for added safety through the use of two Proton and two N1 launches to get a single man safely to the lunar surface and back. Under this scenario, two Proton rockets would launch automated Ye-8LS lunar rovers to the surface. These would scout the local terrain. The rover would park at the selected site and serve as a beacon for the LK landers that would follow. An N1 would be launched with an unmanned LOK and the backup 'reserve' unmanned LK (LKr). The LKr would land with minimum propellant consumption, homing in on the Ye-8LS beacon. The LOK would photograph the site from lunar orbit and then return the film to earth. One month later, the manned expedition would be launched. A single cosmonaut would ride a second LK to the lunar surface, again using the homing beacon. If there were any problems, the cosmonaut could walk or drive one of the rovers to the LKr and have a second chance to get back to the LOK in lunar orbit. The Ye-8LS were equipped with a driver control panel and supplies of oxygen and water for the Krechet suit. They rover reach 1.2 km/hour for a slow-motion ride to the other lander if necessary.
Also in 1967 a substantive plan for test of the LOK in earth orbit was developed. The earth-orbit versions of the LOK was dubbed the T1K. By March 1968 it was planned three flights would be made launched by Chelomei's Proton booster in October-November 1968. The last of these would be manned and involve docking with the T2K test version of the LK lunar lander. In August 1968 discussion of using the Yastreb lightweight space suit for these missions was underway, Incredibly, at the same time, fundamental arguments over the rendezvous and docking system continued. Some factions preferred the Igla system which was being proven on the orbital version of Soyuz. Others preferred the Kontakt system. The decision, inexplicable in retrospect, was to continue with the Kontakt system for the L3.
Following the successful flight of Apollo 8 around the moon in December 1968 the project managers finally realized they had no chance for beating the Americans to a lunar landing. N1's 3L through 6L would not have enough payload for a landing mission. The LOK and LK were not nearly finished and the landing scenarios had been redrafted three times since the project had begun. A council of chief designers considered the options:
A meeting of the Council of Chief Designers on 24 January 1969 made some brutal recommendations to the Soviet leadership. The T1K, T2K, and L1E were cancelled. The LOK and LK, although overweight, would continue in low-priority development. A month later the first launch attempt was made with the N1. N1 3L cleared the pad but an engine control system fault shut down all first stage engines after 68 seconds of flight. It was considered a typical first flight test and the program was not jeopardized.
On 29 and 30 May 1969 the launch commission for the next launch, N1 5L, was held. Mishin pushed for a decision, if 5L was successful, to launch the first LOK aboard N1 6L by the end of 1969. Mishin expected to have an all-up spacecraft by then, fully equipped with the fuel cells, the digital computer from NIIAP, the Kontakt docking system, and the Geofizika optical docking system. The cryogenic lox and LH2 for the LOK's fuel cells would be pumped aboard the spacecraft once the rocket was on the pad. The safety issues of handling LH2 was a source of continuing concern for the military. There was also a great deal of skepticism of Mishin's ability to produce a complete LOK by year's end.
Following the spectacular failure of N1 5L on 3 July 1969 the flight schedule was modified again. It now read as follows:
Work continued on the LOK. Arsenal was still having problems in January 1970 with the forward engine system. By February 1970, of 16 LOK's authorized, only three were in ground test for possible future flight operations. Seven were partially assembled, and the remainder existed only as unassembled parts.
A crash program had been initiated to develop the Salyut 1 space station before the American Skylab. Development of the LOK and LK were given a very low priority. On 14 April 1971, at an expert commission reviewing the N1, Keldysh suddenly changed his long-standing support for the L3 and listed a series of 'mandatory changes' which would completely invalidate the LOK/LK design. Among these were:
It was decided not to risk functional spacecraft in further N1 tests until the booster had proven itself. Therefore 6L and 7L would carry only LOK and LK mass models, with 8L now scheduled to carry an all-up automated LOK and LK spacecraft. During 1971, LOK certification tests began in earnest, including water-landing tests and launch escape system live fire tests. The fuel cells were finally tested in 1971-1972, producing 4.5 kW at 60% efficiency.
By this time, however, Mishin's team was already concentrating on a completely new spacecraft - the L3M - that would make a direct landing on the lunar surface. This would be joined to new Lox/LH2 propulsion stages in earth orbit using multiple N1F launches - the same scenario originally advocated by Korolev. A state commission under Keldysh studied the alternatives throughout 1971, and the final conclusion was to abandon any use of the original L3 (LOK+LK) lunar orbit rendezvous spacecraft in a manned landing. The assets already built would be used only for unmanned tests of the N1. Any Soviet manned lunar landing would rely on the L3M and multiple N1F launches to support a landing no earlier than 1977. But these plans were never fully funded, and in the absence of any formal go-ahead, Mishin continued to complete qualification and flight test of the LOK.
Therefore the payload for N1 7L was changed again, to be the first actual test flight of the LOK (article 6A was selected for the honor). A mock-up of the LK would accompany it on a lunar orbital mission. The flight plan for the mission was issued on July 19, 1972. N1 7L was to place the 89,803 kg L3 stack into a 200 x 740 km earth orbit at a 50.7 degree inclination. After 24 hours of on-orbit tests the Block G translunar injection stage would hurl the payload toward the moon. However even with the underweight payload the Block G could not complete its mission in this configuration. The Block D would have to fire for 44 seconds after the Block G had depleted its propellants in order to reach earth escape velocity. In case of a failure to reach a lunar trajectory, the LOK was to separate, conduct operations in earth orbit, and then deorbit for a splashdown in the Indian Ocean.
After four days transit to the moon, with two mid-course corrections, the Block D would fire to place the assembly into a 175 km circular lunar orbit at 98.5 hours into the flight. The Block D would shape the orbit to a final 40 km x 175 km orbit on maneuvers on the fifth and 27th orbits. The LOK was to conduct photographic sessions of potential future landing sites on orbit 14, 17, 34, and 36. After 3.7 days in lunar orbit, the LOK's forward living compartment would separate and the Block I engine would fire to put the spacecraft on a translunar trajectory. Eight minutes prior to re-entry the descent module would separate, curve around the north pole of the earth, and splash down in the Indian Ocean.
The digital computer and inertial platform aboard the LOK were responsible for guiding the Block G, Block D, and LOK during all flight maneuvers after earth orbit insertion. The computer used Tropa integrated microprocessors developed by the Ministry of Electronic Industry. During integration and test of the L3 assembly at Area 2B at Baikonur, many problems arose with the digital computers. Clearing them became a pacing item for the launch. Although electrical tests were completed on 14 October 1972, computer glitches on 27 October led to further delays. At the
LOK Cutaway Detail Credit: © Mark Wade |
LOK EO Detailed cutaway of LOK Power Module. Credit: © Mark Wade |
LOK DM Mass model of LOK descent module for reentry from lunar distances. Credit: © Mark Wade |
LOK Overhead Overhead view of LOK lunar orbiter. |

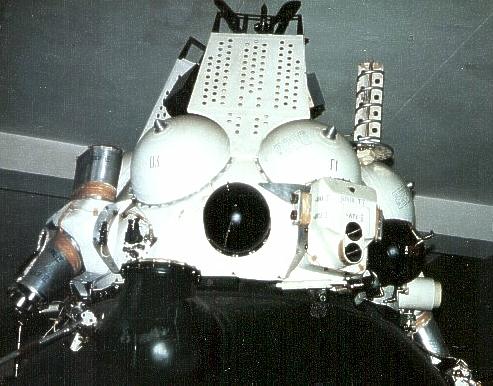

Kontakt Docking Mech Kontact docking grappler. The three arms at the bottom faced outward from the docking assembly. MAI, March 1994 Credit: © Dietrich Haeseler |
LOK Docking Assy Close-up view of LOK orientation engine unit and docking assembly at Korolev School. The docking system in this example is covered with flat plates. Credit: Jakob Terweij |
LOK OM Three views of sectioned LOK orbital module at MAI. Credit: © Mark Wade |

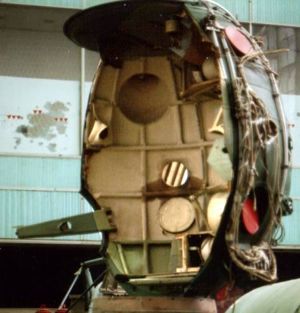

LOK OM View View of LOK OM toward hatch. The cupola for docking is the circular depression in the to of the wall. Credit: © Mark Wade |
LOK OM View View of LOK OM exterior, view toward hatch on far wall. The red covers and other exterior portholes are for the cameras of the lunar surface photography system. Credit: © Mark Wade |
LOK controls Work station inside LOK orbital module. These are the controls for the lunar photography system. Credit: © Mark Wade |
LOK controls LOK OM circuit breaker panel toggle switches. The two on the top left are for the Krechet and Orlan suit circuits. Credit: © Mark Wade |
LOK Orbital Module LOK Orbital Module, view of main control panel dummy. The standard chronograph and sequencer switches were here. Credit: © Mark Wade |
LOK Orbital Module LOK Orbital Module, view up from the entry hatch from the Descent Module to the ceiling. Note air conditioning equipment. Credit: © Mark Wade |
LOK Orbital Module LOK Orbital Module, close-up of cupola for use of cosmonaut in docking with LK. Credit: © Mark Wade |
LOK Orbital Module LOK Orbital Module control station above hatch entrance. Main controls are on the blue panel; the green panel is a breaker panel. Credit: © Mark Wade |
LOK Descent Module LOK Descent Module and Orbital Module Credit: © Mark Wade |
DM Thrusters Detail of thrusters of Soyuz / L1 descent module. These hydrogen peroxide monopropellant thrusters provided orientation of the capsule before and during re-entry. Credit: © Mark Wade |
LOK Block I forward View of the dome covering the pressurized instrument compartment of the LOK. Credit: © Mark Wade |
S5.51 LOK engine The complex plumbing fed numerous smaller attitude control thrusters at the base of the LOK. Credit: © Mark Wade |
N1-L3 shroud Rare shot of n N1-L3 shroud separation test. Proof that the hardware development reached an advanced phase. Credit: RKK Energia |
LOK-LK Drawing Unusual alternate diagram of LOK and LK lunar craft in docked configuration, with bottom view of LK. Korolev School. Credit: Jakob Terweij |
Korolev and Isayev Credit: © Mark Wade |
GE Apollo vs Soyuz Comparison of GE Apollo and Soyuz LOK lunar orbiter spacecraft. |
LOK Lunar Orbiter The Soyuz 7K-LOK lunar orbiter spacecraft to be used in the L3 lunar landing project complex. Credit: © Mark Wade |
Zond Credit: Manufacturer Image |
N1-L3 drawing N1-L3 drawing at Kaluga Credit: © Mark Wade |
L3 Cutaway Dimensioned Russian cutaway drawing of L3 manned lunar landing complex. |
Work on the original N1-L3 had begun in 1963. This had been preceded by two years of working on a draft project for the LK lunar lander and its propulsion system. But there was no money for full scale development -- no code name from Gosplan against which to charge such work. It was annoying that Chelomei, Glushko, and Yangel were wasting resources on alternate designs at the same time. Additional Details: here....
A two-day conference is held at IAKM to review requirements for trainers and task simulators over the next 6 to 7 years. The plan includes basic instructional versions of planned spacecraft, trainers for flying around the moon, and a mock-up of the TMK Heavy Interplanetary Spacecraft. These will require a new facility of to 7,000 square metres. Trainers and strands at TsPK will be housed in building D, a hangar-type facility. The TBK-60 thermal/barometric chamber will be housed in a single hangar. To fully specify TsPK trainers and stands for the lunar mission, trainers for space navigation, and military combat spacecraft will not be completed until 1965.
Central Committee of the Communist Party and Council of Soviet Ministers Decree 655-268 'On Work on the Exploration of the Moon and Mastery of Space--piloted LK-1 circumlunar and L3 lunar landing projects and the Ye-6M lunar lander' was issued. Chelomei was to develop the three-stage UR-500K booster and LK-1 spacecraft for the manned lunar flyby. Korolev was to develop the totally different N1 booster and L3 spacecraft complex for the manned lunar landing. First launch of the N1 was to be by the first quarter 1966, with manned lunar landings in 1967 to 1968. Reprioritization led to work being stopped on Korolev's Zvezda 6-man orbiting weapons platform by mid-1965, after a huge mockup had been built.
Korolev felt that if he had the full support of the Communist Party, the military, and industry he could achieve this goal, and this decree ordered such support. The USSR would be first on the moon. But in truth the draft project behind the decree had not solved all of the technical problems, or provided a solution on how to achieve the required payload on either the booster or spacecraft side. New technology features required for success of the scheme included an advanced guidance system in the N1 third stage equipment bay, the enormous fuel tanks in the N1 first stage, and the Lox/LH2 fuel cells needed for the LOK lunar orbiter. But the real technical problem with the N1-L3 design was the total lack of any weight growth reserve. Even thought the systems had not even been developed yet, engineers were fighting over tens of grams in their weight allocations, let alone the kilograms normally at issue.
Development of Korolev's Soyuz A-B-V, a competing circumlunar project, was evidently still authorised, although it duplicated Chelomei's LK-1.
Korolev speaks privately to Chertok. Kozlov has told him it will be impossible to build an N1 with the 93 tonne payload capability until the fourth flight article. The L3 concept was still the same as in the August decree - 2 cosmonauts aboard the LOK orbiter, one aboard the LK lander. Korolev asks Chertok to take 800 kg out of the weight budget for the L3. Chertok informs him that they are already 500 kg over the August budget. This is still without all the unknowns of the automated lunar landing being solved. Additional Details: here....
There were two camps on the N1-L3 control systems. One group was within OKB-1, and had developed the systems for the Vostok and Zenit spacecraft, under the personal oversight of Korolev. They stressed the maximum quality and reliability in their systems. The second group had worked with Pilyugin, and had designed the systems for the Mars, Venus, Luna E-6 probes, the R-9, RT-1, RT-2, and GR-1 missiles; and piloted spacecraft. Their design emphasis was on maximum usability and output. Pilyugin had been named chief designer of the control system for the N1-L3. Additional Details: here....
Interdepartmental Scientific-Technical Council on Space Research (MNTS-KI) Decree 'On approval of the L3 draft project' was issued. The decree followed a review by a Keldysh-led Academy of Sciences state commission the previous December. The decree moved the first flight of the N1 to the end of 1966. Additional Details: here....
Chertok argues for the necessity of adding one Soyuz to production and using it as an iron bird - a hot mock-up on which avionics and electrical systems can be integrated and tested. Gherman Semenov and Turkov convince Korolev that this cannot be done within the existing schedules.
Kamanin meets with Korolev at 15:00 to discuss crew plans. As Soyuz pilot candidates, Kamanin proposes Gagarin, Nikolayev, Bykovsky, Komarov, Kolodin, Artyukhin, and Matinchenko. Korolev counters by proposing supplemental training of a supplemental group of engineer-cosmonauts from the ranks of OKB-1. He calls Anokhin, his lead test pilot, informs Korolev that there are 100 engineers working at the bureau that are potential cosmonauts candidates, of which perhaps 25 would complete the selection process. Kamanin agrees to assist OKB-1 in flight training of these engineer-cosmonauts. Kamanin again proposes Volynov and Katys as prime crew for the Voskhod 3 12-15 day flight. Korolev reveals that, even though Kamanin will have the crew ready by October, the spacecraft for the flight may not yet even be ready by November - Kamanin thinks January 1966 is more realistic. The discussion turns to the female EVA flight - Ponomaryova as pilot, Solovyova as spacewalker. It is decided that a group of 6 to 8 cosmonauts will begin dedicated training in September for lunar flyby and landing missions. Korolev advises Kamanin that metal fabrication of the N1 superbooster first article will be completed by the end of 1965. The booster will have a payload to low earth orbit of 90 tonnes, and later versions with uprated engines will reach 130 tonnes payload. Korolev foresees the payload for the first N1 tests being a handful of Soyuz spacecraft.
Kamanin looks ahead to the very difficult tasks scheduled for 1966. There are to be 5 to 6 Soyuz flights, the first tests of the N1 heavy booster, the first docking in space. Preparations will have to intensify for the first manned flyby of the moon in 1967, following by the planned first Soviet moon landing in 1967-1969. Kamanin does not see how it can all be done on schedule, especially without a reorganization of the management of the Soviet space program.
The VVS General Staff reviews a range of documents, authored by Korolev before his death, and supported by ministers Afanasyev and Petrovskiy. The schedules for the projects for flying around and landing on the moon are to be delayed from 1966-1967 to 1968-1969. A range of other space programs will similarly be delayed by 18 to 24 months. An institute for tests of space technology will be established at Chelomei's facility at Reutov. The IMBP will be made the lead organization for space medicine. Responsibility for space technology development will be moved from MOM to 10 other ministries. 100 million roubles have been allocated for the establishment of new research institutes. Kamanin is appalled, but Malinovskiy favours getting rid of the responsibility for these projects. The arguments over these changes - which reduce the VVS role in spaceflight - will be the subject of much of Kamanin's diary over the following weeks.
Kamanin presents his plan to train 5 to 6 crews for the lunar landing mission over a 30 month period. Only experienced cosmonauts, with prior spaceflight experience, will be assigned to these crews. Kamanin lays out for the VVS leadership the complex series of events the cosmonauts will have to complete in the L3 lunar-orbit rendezvous scheme, including transfer between spacecraft of a single lunar landing cosmonaut in free space in lunar orbit. Crews need to be formed immediately, with two cosmonauts per crew - the L3 mission commander, and the second cosmonaut who will land on the moon. In order to accomplish the mission on schedule, a new air regiment needs to be formed, with the necessary flying laboratories, simulators and trainers, space suits, test stands and surface simulators, and other equipment necessary to train the crew for the mission.
Decree 'On renaming OKB-1 as TsKBEM and OKB-52 as TsKBM' was issued. In 1966 Afanasyev reorganised the military industrial complex. OKB-1 was redesignated TsKBEM. Sergei Osipovich Opakhin was made First Deputy within the new organization.
However within TsKBEM there were no relative priorities for the projects competing for resources. The R-9 and RT-2 ICBM's, the orbital, circumlunar, and lunar orbiter versions of Soyuz, the LK lunar lander, the N1 booster -- all were 'equal'. It seemed folly to be pursuing the orbital ferry version of the Soyuz when no space station had to be funded. But it was felt flying the spacecraft would solve reliability questions about the design, so it was pursued in parallel with the L1 and L3 versions.
Acting director Mishin held a brainstorming session with this top managers to address "...our inconsistent lunar program". He noted then-current contradictory approaches: 1. Return to a two-launch scheme (podsadka, as baseline); 2. Keep with direct landing; 3. Use a Block D with storable propellants; 4. Use the 7K-OK as the designated return spacecraft. He noted that the L1 program was a diversion for the bureau to the core objective of landing a cosmonaut on the moon (the L3 program). Among the advantages of continuing with the L1, he noted that it "Utilizes the 7K-OK" - evidently there was no purpose for the spacecraft beyond the L1 mission in the podsadka scenario. He asks for frank opinions from his managers. V Rauschenbach noted that they "..have to do the L-1 … and therefore we will have to use a 2-launch scheme based on the L1-S". BE Chertok: discussed the rendezvous and docking systems for the various spacecraft: L1-S - "Igla"; LOK - "Kontakt" (since "Igla" cannot be used on the LOK (due to mass considerations); or a new system for the LOK. (Mishin Diaries 1-226) Here we have an indication that the L1 podsadka version did use the Igla system, which makes complete sense, since the Soyuz 7K-OK missions conducted dress rehearsals for podsadka using this system to rendezvous and dock two 7K-OK spacecraft in earth orbit.
From 1963-1965 Ustinov was both head of the Soviet for the National Economy and the First Secretary of the Presidium of Soviet Ministers. He supported civilian space projects and instructed the military to co-operate in them. But after Khrushchev was ousted, Ustinov had less influence with the Ministry of Defence.
After the death of Korolev in January, a letter was sent to the Central Committee requesting that Mishin be appointed director of OKB-1. Ustinov tried to line up support for Mishin, but by the time of the first first Saturn IB orbital flight on 26 February 1966, no decision had been made. America was progressing on the path to the moon, but Russia was stalled. An alternate that had been considered was Sergei Okhapkin, another Deputy Chief Designer at TsKBEM. But Okhapkin knew only spacecraft, he had never developed complete launch-booster-spacecraft systems. By the time Mishin was appointed, it was clear that the race was lost. The American's planned their first Saturn V launch in September 1967 and their first manned flight in 1968. Mishin could not expect trials of the LK lunar lander until 1969 at the earliest. There were insufficient funds allocated, and the schedule had no allowance for test flight failures. Ustinov, Morozhin, and Keldysh pointed fingers as to who had presented such unrealistic schedules to the Politburo. Keldysh now supported unmanned robot lunar landers in development by Babakin. Even these would not land until 1970, allowing three years of flight trials to achieve reliability. Khrushchev, it seemed, was to blame for such enormous unaffordable projects. This in turn put Ustinov in danger, as Khrushchev's point man for space.
Bushuyev proposed a two launch variation on Korolev's single-launch scheme. The increased-payload version of the N1 with six additional engines was not planned to fly until vehicle 3L. 1L and 2L were to be technology articles for ground test with only the original 24 engine configuration. At that time the first Apollo test flight was planned by the end of 1966, and the US moon landing no later than 1969. The Soviets expected the first test of their LK lander in 1969, and concluded they could not expect to land a Soviet man on the moon until 1972. Additional Details: here....
Kamanin organises the cosmonauts into the following training groups:
Rudenko agrees with Kamanin's plan, except he urges him to assign more cosmonauts to the Soyuz 7K-OK group, and include OKB-1 cosmonauts in the 7K-OK, L1, and L3 groups, and Academy of Science cosmonauts in the L1 and L3 groups.
These cosmonaut assignments were in constant flux, and many cosmonauts were assigned to train for more than one program - resulting in multiple claims in later years that 'I was being trained for the first moon flight'.
Mishin's draft plan for the Soviet lunar landing was approved by an expert commission headed by Keldysh. The first N-1 launch was set for March 1968. At same meeting, Chelomei made a last ditch attempt to get his revised UR-700/LK-700 direct landing approach approved in its place. Although Chelomei had lined up the support of Glushko, and Mishin was in a weak position after Korolev's death, Keldysh managed to ensure that the N1-L3 continued. However continued design work on the LK-700, the UR-700 booster, and development of the RD-270 engine were authorised.
The weather continues to deteriorate, and Kamanin considers moving the Tu-104 and cosmonauts to Krasnovodsk in order to get the 24 necessary zero-G flights before launch. At 11:00 the State Commission meets at Area 31. Present are Kerimov, Mishin, Rudenko, Kamanin, Komarov, Bykovsky, Khrunov, Yeliseyev, Anokhin and others. Mishin describes the status of preparations of Soyuz s/n 1, 2, 3, 4 for launch. He notes that the L1 and L3 lunar spacecraft are derived from the 7K-OK, and that these flights will prove the spacecraft technology as well as the rendezvous and docking techniques necessary for subsequent manned lunar missions. Feoktistov and the OKB-1 engineers say a launch cannot occur before 15 January, but Mishin insists on 25 December. That will leave only 20 days for cosmonaut training for the mission, including the spacewalk to 10 m away from the docked spacecraft. Faced with the necessity for the crews to train together as a team prior to flight, Mishin at long last officially agrees to the crew composition for the flights: Komarov, Bykovsky, Khrunov, and Yeliseyev as prime crews, with Gagarin, Nikolayev, Gorbatko, and Kubasov as back-ups. However a new obstacle appears. KGB Colonel Dushin reports that Yeliseyev goes by his mother's surname. His father, Stanislav Adamovich Kureytis , was a Lithuanian sentenced to five years in 1935 for anti-Soviet agitation. He currently works in Moscow as Chief of the laboratory of the Central Scientific Research Institute of the Shoe Industry. Furthermore Yeliseyev had a daughter in 1960, but subsequently annulled the marriage in 1966.
Later Feoktistov works with the crews on spacecraft s/n 1 to determine the feasibility of the 10-m EVA. The cosmonauts suggest a telescoping pole rather than a line be used to enable the cosmonaut to be in position to film the joined spacecraft. Bushuyev is tasked with developing the new hardware.
At this point the Ye-8 would be delivered to the moon by a UR-500K launch vehicle. The basic constraint was the 5300 kg payload capability of the Block D to translunar injection. This meant tradeoffs in the accuracy of the Ye-8's initial landing versus its lifetime on the surface waiting for arrival of the LK. It was agreed that a working group would meet the next day to develop final specifications Ye-8 and a more detailed outline of the N1-L3 expedition using Ye-8. (start-up sequence, the time, the connections between LK, LOK and Ye-8, the means for determining the location). KD Bushuyev was to study the backup LK concept. (Mishin Diaries 1-235)
Soviet government approves plan to land cosmonaut on moon by end 1968. N-1 test plan approved, envisioning third quarter 1967 as beginning of flight hardware construction. Fall-back project would be manned circumlunar mission. First manned L1 mission imagined as early as June 1967. First N1 launch by March 1968.
The following is the schedule set be decree for the L1 and L3 projects:
Serial # Mission Date 2P Develop Block D stage Feb or Mar 67 3P same Mar 67 4L Unmanned lunar flyby May 67 5L Unmanned lunar flyby Jun 67 6L Manned lunar flyby Jun or Jul 67 7L&8L Manned lunar flybys Aug 67 9L&10L Manned lunar flybys Sep 67 11L&12L Manned lunar flybys Oct 67 13L Reserve spacecraft N1-3L Serial # Mission Date 3L Develop LV & Blocks G&D Sep 67 4L Reserve 5L LOK/LK unmanned Dec 67 6L LOK/LK unmanned Feb 68 7L Manned LOK/unmanned LK Apr 68 8L Manned LOK/unmanned LK Jun 68 9L Piloted LOK/unmanned LK with LK landing on moon Aug 68 10L First men land on moon Sep 68 11L Reserve 12L ReserveKamanin's personal opinion of this schedule - manned L1 flights may occur before the end of 1967, but there will be no lunar landing until 1969.
UR-500K/L1 project will consist of three phases. Phase I will be dedicated to development of the Block D translunar stage, using prototype, incomplete L1 spacecraft. Phase II will conduct lunar flybys with complete but unmanned L1 spacecraft. Phase III will fly Soviet cosmonauts around the moon. The N1/L3 project will consist of five phases. Phase I will use the N1 and the 7K-L1A spacecraft. This will be used primarily to test out the Block G translunar and Block D lunar orbit insertion stages, but will also conduct lunar flybys, returning photographs of the lunar surface to the earth. Phase II will use N1's to fly L3 spacecraft with an unpiloted LOK lunar orbiter and an unpiloted LK lunar lander. Phase III, the first manned missions, will use N1's to fly L3 spacecraft with a piloted LOK lunar orbiter and an unpiloted LK lunar lander. Phase IV will fly a piloted LOK lunar orbiter and an unpiloted LK lunar lander, that will be landed on the lunar surface. In Phase V N1-L3 number 10L is to launch the first manned landing on the moon in September 1968. N1-L3 numbers 11L and 12L were back-ups, in the event any of the planned earlier missions failed. Additional Details: here....
Consider the shortfall in his request compared with the challenge of beating the Americans to the moon!
Review with Company Management on Occasion of Tenth Anniversary of Sputnik 1
Plan for 1968.
1. Funding:
R&D - 7.5 million Rubles. (26 million requested).
including YaRD nuclear rocket engine- 6 million., MKBS - 0.5 million., L-5 - 0.5 mln., Yantar - 0.5 million.
Experimental design work - 266 million. (Requested 333 million).
Funded 3 sets N1-L3 instead of 6 sets.
For 7K-OK - 11, 12, 13, 14 (shortfall 20%).
N1-L3 (3 sets - 207 million., Including 38 million experimental work. Stages A, B, V, G - 22.8 million. Payloads (LOK, LK, Block D, GO) - 9.5 million. Blocks E and I - free of charge. (under direct contract with Isayev).
2. Plan - does not meet the 5-year plan. Not included at all:
- Modernization of the N1-L3.
- In R&D - Modernization of the RT-2M (in full).
- EYaRD (nuclear electric propulsion)- instead of in R&D - to search for funding.
Attending are Kuznetsov, Gagarin, Khlebnikov. There are three training groups: Soyuz, L1, and L3. Mishin and the MOM are holding up further training of cosmonauts until the VVS agrees to accept Mishin's candidates from TsKBEM. In any case, Mishin's attitude is that 'automation in space is everything. Humans in space are only supposed to monitor the operation of automated systems'. L3 cosmonauts selected by the VVS are: Leonov, Bykovsky, Nikolayev, Popovich, Voronov, Khrunov, Gorbatko, Artyukhin, Kubasov, Makarov, and Rukavishnikov. The official requirements: balanced composition of a crew according to mass requirements (no more than 70 kg weight per cosmonaut), and the ability to monitor fully automated function of the L3. According to official documents, the crew's primary function is to guide the flight, but now Mishin intends that their primary role will be as subjects of psychological and physical observations to establish the adaptation of the human organism to space flight).
First Mishin was pushing the 60-year-old Anokhin for spaceflight, now the invalid Feoktistov. Feoktistiov suffers from gastrointestinal ulcers. Tyulin and Kerimov are of one voice in the matter - this is not even a question that can be raised - sick is sick, period. The L1 and L3 crews will have to endure eight to ten days of orbital flight. They can only be between 170 and 175 cm tall, and can have a maximum weight of 70 kg. Mishin insists that he doesn't even need military pilots for the L1 and L3, and therefore doesn't need to decide crew compositions until the middle of 1968, and then only 'his' engineer cosmonauts from TsKBEM should be considered. The Marshal interrupts Mishin, angrily reminding him that the space program is a national enterprise, not something being accomplished by 'your' spacecraft or 'your' cosmonauts. A three hour-long bitter debate ensues, with no resolution on crew selections. The final conclusions are only that the crews will consist of one pilot, and one engineer, and that Feoktistov will never be allowed to go into space.
Mishin wants only his organisation to build L3 trainers, not the VVS. A whole series of previously-unmentioned trainers and simulators are mentioned, included the Turbolet, a V-10 helicopter with a lunar cabin, etc. For the L3 simulator Mishin wants to develop the specification documents without inputs from the VVS and have it built only to Mishin's requirements. This is rejected by Kamanin, who insists on a decision by 20 December, with issuance of the specifications for the L3 trainers with the input of VVS. If two simulators are buit, one must be installed at TsPK and the other at TsKBEM. If only one is built, it will have to be at TsPK.
He is shown the Volga and L1 trainers, takes a seat in the trainer, and is given a simulated space flight. At the air base he reviews the aircraft and the TBK-60 altitude chamber. Throughout the tour, Mishin constantly wore a soft expression and used coarse language. Afanasyev was briefed on and recognised problems with development and delivery of the Salyut digital computer needed for the L1 guidance system. But he was not told that cooperation had broken down totally on the L3 simulator development and crew selection.
The 'big' Soviet of Chief Designers meets and the three-launch landing concept developed a month earlier is presented in detail. Pilyugin pointed out that this was a typical contradiction. Mishin had just made a presentation to the expert commission justifying that the one-launch scheme was safe and reliable. Now they wanted to put forward a new scheme because the one-launch scheme was unsafe and unfeasible. Additional Details: here....
In preparation for a Soviet of Chief Designers four days later, detailed consideration of many issues was underway. Among them, changes to the baseline LK orbit and ascent trajectories to allow rendezvous with the waiting LOK even after a delay of more than six orbits in departure; and changes to the landing profile to prevent shrapnel from jettison of the LKR's Block D lunar crasher stage impacting the waiting cosmonaut's LK. 250 liters of increased propellant would be required in the LKR for a higher Block D jettison; or the Block D could make a maneuver after separation to assure it would impact well away from the active landing site. (Mishin Diaries 2-119)
Mishin certified to MAP on 5 March that the Soyuz parachute system development is complete, but Tkachayev has dissented, saying that the system was unreliable and overweight (this from the same chief designer that certified the previous design as having an 0.999 reliability!). The parachute trials will not be finished until May - meaning there will be no manned Soyuz launch in April. This problem is holding up the L1, L3, and Almaz projects as well.
Titov is going to Italy, Feoktistov to Hungary. The 30 month program for the L3 lunar landing is settled. The cosmonauts already began training in January. The first LK lunar lander will be tested in low earth orbit in the second half of 1969. The first Soviet manned lunar landing cannot take place any earlier than 1970-1971. The resolution had set the date as 1967-1968, but the N1 and L3 will not be ready in time. The L3 is still conceptual, a purely paper spacecraft. The first N1 was to have been moved to the pad by March of this year, but it won't even make that milestone by May.
Marshal Zakharov has consulted with Ryabikov at Gosplan on what commitments Grechko has made from Ministry of Defence funds for L3 recovery forces. Gosplan advised him that 800 million roubles and 21,000 staff were committed, but the justification for these amounts were not methodically developed. Mishin is now saying that hundreds, not thousands of cadres will be required, see he can set the return capsule down in within the confines of the cosmodrome.
VVS has been charged with arranging for ocean recovery of the L3 capsule in case it splashes down in the Indian Ocean since 1966. TsNII-30 did the research work under project 'Ellips', resulting in the recommendation that the VVS and VMF jointly develop the air and naval forces to recover the capsule at sea, at a cost of 800 million roubles. The Ellips concept requires that the L3 capsule be equipped with radio beacons and dye markers. Despite knowing this for two years, Mishin has done nothing to implement these features into the spacecraft.
Vershinin looks bad after his surgery. His loss would be a blow for Kamanin's cause - Vershinin was steadfast against the unobjective positions of Mishin and Smirnov. Vershinin had just sent yet another letter about the procurement of the 16 m centrifuge for the TsPK. This is a six-year long story. The VVS has been trying to procure this essential piece of cosmonaut training equipment since 1962, but it still has not been delivered. Vershinin also has issued a letter on the L3 recovery force issue. He points out that the resolution of the Central Committee ordered the expenditure of 600 million roubles and the commitment of 9,000 men for recovery services. Another 400 million roubles and 12,000 men were earmarked by the Rocket Forces. Despite this huge commitment, Mishin now says he doesn't need any of them, that he can bring his L1 and L3 spacecraft to precision landings within the confines of the cosmodrome, eliminating the need for any Indian Ocean recoveries. This optimism is not accepted, but it is agreed the total requirement can be reduced to 400 million roubles and 7,000 men, through use of lighter recovery ships of the Leninskiy Komsomol class, and the use of three airborne relay stations instead of nine.
Glushko has a private conversation with Isayev at the N1 MIK during the Soyuz 3 launch preparations. Glushko revealed to Isayev that in 1961 he had offered Korolev a compromise - if Korolev would use the same 'packet' scheme for the N1 that he had used on the R-7, so that the individual engine modules could be individually tested on the ground before flight, Glushko would give up his insistence on the use of storable propellants. However, after checking with Mishin, Korolev would not compromise. Additional Details: here....
The previous launch date of 25 November has been pushed back to January 1969. The N1 has completed a good cycle of ground tests, but work on the L3 has not even begun. There is no news when it will be ready. The L3 plan called for the first article to be ready in March 1968. 20 cosmonauts from the L1 and Soyuz groups were to have trained on the spacecraft. But MOM never issued the implementation plan to the industrial enterprises to begin work on the spacecraft.
A 'small Soviet' of designers was held to review whether to continue pursuing the N1 launch vehicle or not. Although a first manned lunar landing was not achievable, the N1 could still be used to establish a lunar base by the beginning of the 21st Century. Additional Details: here....
The training for the Soyuz 4 and 5 flights was completed last night. Today the crews undergo medical tests and start preparation of their flight logs/flight plans. On the return flight to Moscow Shatalov, Beregovoi, Severin, Kamanin, and Mnatsakanian get into a heated argument. The cosmonauts attack Mnatsakanian's Igla automated docking system. It limits docking manoeuvres to periods when the spacecraft are flying over the Soviet Union due to the requirement for ground stations to receive live television. The Americans worked only on the Apollo spacecraft for the last two to three years, while the Soviets have divided their efforts on no less than five spacecraft types: the L1, L3, Soyuz, Soyuz VI, and Almaz. This is all Mishin's fault...
Mishin meeting with his guidance expert, NA Pilyugin, to consider the possibility of 2 launch schemes: with Ye-8 and without Ye-8 OV. All possibilities to improve the accuracy of the landing without the Ye-8 were to be examined. The first N1 missions would rehearse the two-launch scenario, with the Ye-8 being launched by a UR-500K and an L3S (orbital version of the L1S) standing in for the LOK (no LK being available yet).
Afanasyev and Keldysh chaired the unusual and extraordinary Soviet of the chief designers. Mishin opened with an emotional plea not to cancel the N1. He justified the delays and failures by saying that he had not been given sufficient budget to conduct necessary experimental and qualification tests of systems before flight. Additional Details: here....
Marshal Krylov, Commander of the Strategic Rocket Forces, headed the meeting. The conference room was mobbed - many unfamiliar faces were in attendance - everyone wanted to witness the historic event. General Kurushin, Commander of Baikonur, stated that he was against proceeding with the launch, due to the many unresolved technical issues, unless he could somehow be persuaded otherwise. He pointed out that Mishin had made a large number of changes to the N1 to increase its payload. However these at the same time negatively impacted the booster's reliability. Additional Details: here....
A 50 minute presentation is given on space plans. Russia plans to fly no less than six different types of manned spacecraft in 1969-1970 - the Soyuz, L1, L3, Almaz, Soyuz VI, and Spiral. This will result in a decisive answer to the American Apollo programme within two to three years. No N1 launch with the complete L3 lunar landing spacecraft is planned until 1970. Approval is sought for the VVS to buy 10 Soyuz spacecraft for continued manned military flights in low earth orbit. Otherwise between the second half of 1970 and during all of 1971 there will be no spacecraft available for manned flights Additional Details: here....
Kamanin makes a speech to the VVS Soviet, setting forth again plans for military research in space. His presentation shows how far the USSR is behind the Americans, and the need to regain the lead. He again proposes 10 to 12 military Soyuz flights beginning in the first quarter 1970. This will fill the gap until Soyuz VI and Almaz will begin flying in 1972. Kutakhov is categorically against these Soyuz flights but, under pressure from others, still agrees to form a commission to study the matter. Reference is made to a Ministry of Defence decree of 7 January 1969.
Over two days a State Commission reviewed all of the conclusions of the N1 3L failure investigation and the readiness of N1 5L for flight. All of the fixes identified to remedy the 3L failure had been incorporated into 5L. It was felt that the behaviour of the systems in fire conditions were understood and appropriate measures had been taken. The wiring had been rerouted and insulated. Barmin wanted the system not to shut down any engines under any conditions during the first 15-20 seconds of flight, so that the booster would clear the pad and there would be no risk of the pad's destruction. But there was no time to develop such measures before the 5L launch; it could only be added in vehicle 6L. Additional Details: here....
The VPK Military-Industrial Commission issues a decree on the schedule for the rest of 1969. There are to be five launches of Ye-8-5 lunar soil return robots, on 14 June, 13 and 28 July, 25 August, and 25 September. There are to be two launches of Ye-8 Lunokhod robot rovers on 22 October and 21 November. Further manned L1 flights are cancelled. There are no plans made for the L3 since the N1 is not ready.
With the collapse of the work on the N1, the whole reason for Mishin's design bureau's existence simply vanished in the air. A new high-priority project was needed. Korolev had begun development of a Multi-Module Space Base (MKBS) before 1966. However MKBS was to be launched by the N1; as long as this was not available, there would be no MKBS. Almaz on the other hand did not require a new launch vehicle, although the UR-500 was in a period of intense 'baby sickness'. So while TsKBEM was in a period of analysis and instability, Chelomei's Reutov and Fili facilities were building space stations for the Ministry of Defence.
On one of these August 1969 days, three of Chelomei's TsKBM engineers came to the office of Mishin's deputy, Chertok, with a plan to get a space station orbited before the American Skylab. They wanted a collaboration between the two competing design bureaux. Their plan was to take an Almaz spaceframe, install Soyuz systems, add a new docking tunnel with a hatch to reach the interior, and presto - a space station was finished. Tentative discussions with potential allies within Chelomei's design bureau found support there as well. The DOS 'long-duration orbiting station' was the result of this 'conspiracy'.
The Americans were able to pull equal in the race during their Gemini programme, then ahead with Apollo. The Soviet Union is now four to five years behind. Kamanin's accounting:
Meeting of Kamanin with S G Donevskiy. The L3 trainer will not be finished until May 1970 - and the current schedule for the first manned L3 launch is December 1970! But in any case Kamanin assesses the latter date as unrealistic -- there is no rocket or spacecraft in being yet. Later in the day Efimov, Moroz, and Kamanin meet with the female cosmonauts - Ponomaryova, Solovyova, Yerkina, and Kuznetsova. They advise them that despite the letter to the Central Committee asking for an all-female Soyuz flight, it has been rejected. Ustinov, Smirnov, and Pashkov are all opposed to the idea, as are MOM, MAP, AN, and VVS. Kamanin believes the whole female cosmonaut concept was a mistake. Flying Tereshkova in the first place started the whole thing, but now there is no follow-up.
Mishin was opposed to the DOS space station concept - he wanted to pursue the N1-launched MKBS. Afanasyev and Deputy Minister Tyulin wouldn't support the idea either. None of them wanted to take the risk. The only chance was to get to VPK Chairman Ustinov through Communist party channels. The opportunity came on the flight of engineers and management to Baikonur for the Soyuz 6/7/8 flight. Feoktistov had prepared a briefing on DOS, which he presented to Ustinov.
In the euphoria after the return of the Soyuz 6/7/8 crews, the problem was how to get Ustinov to meet further with the DOS 'conspirators'. Mishin had prohibited any meetings by TsKBEM staff with the Communist Party Secretary unless Mishin was also present. Another obstacle was that Feoktistov was not a party member; how could his presence at a party meeting be explained to Mishin later?
In any event these consideations were simply ignored. Feoktistov was present at a party meeting with Keldysh, Afanasyev, Tyulin, Serbin, and the Ministry of Defence's party cell: Strogonov, Kravtsev, and Popov. Keldysh was mainly worried how the project would affect the N1, but was reassured that the N1 had a dedicated work force, and the L3 lunar lander spacecraft engineers and workers that would work on DOS were currently idle and had no part of that work. It was finally decided to go ahead with the DOS no earlier than January, to allow time for Ministry Decrees, approval of a work plan by the VPK, preparation of a decree for signature by the Central Committee of the Communist Party and the Soviet Ministers. Work began on the project in December 1969 under the initial auspices of the Academy of Sciences. Additional Details: here....
The Ministry of Defence and VVS approve the draft DOS resolution. Kamanin has fought against it. He would prefer to develop a single reliable Soyuz spacecraft model by building and flying ten more (there are only four left of the original production lot in assembly). Instead the space leadership keep dreaming up new projects. In Kamanin's view, the DOS and its new Soyuz ferry design join Almaz, Soyuz VI, and the L3 as 'paper spacecraft'. Mishin still thinks he will 'teach the N1 to fly' and complete the L3, but Kamanin thinks the chances of this are nil. There is no coherent plan for Soviet spaceflight.
Mishin's latest plan is land the L3 in the Indian Ocean after return from the moon, but Soyuz is not rated for swells over 3 to 4 balls. Also there is no money for the needed recovery forces. By comparison the Americans have made the sea their home. Their aircraft carriers give them control over 300 times more ocean area than the Soviet Union.
All will have to be on dry land. 500 million roubles would have been necessary to fund the sea forces, and the risk to the crews would have been greater. Kamanin sees the whole bogus controversy as a diversionary tactic of Mishin's to take attention away from the fact that the L3 spacecraft is in fact nonexistent - as is its N1 rocket. An additional 300 million roubles are needed to achieve a 'flying' N1. A completely new solution to the lunar landing problem needs to be worked out. Shatalov worked today with Grechko to lay out the program for French President Pompidou's visit to the Baikonur cosmodrome. Pompidou wants to see two live rocket launches, and Shatalov will show him the Soyuz spacecraft.
Zond 8 is recovered only 15 minutes after splashdown by the vessel Taman. Of five Zonds recovered, this was the only one to fly over the north pole. The remainder re-entered over the south pole. The reason for this was the need to fly over tracking stations on Soviet territory in order to get trajectory updates that allowed a precise landing after the second plunge into the atmosphere. This was the reason Mishin now wants a water landing for the L3. The dilemma is that after a first dip into the atmosphere over the North Pole, tracking for a precision landing is possible, but then the spacecraft cannot land on Soviet territory. Re-entering first over the South Pole means that no trajectory updates are available, but then the spacecraft can land only imprecisely somewhere on Soviet territory.
15 L1's were completed, of which only five ever returned to earth. With this successful final recovery, the programme is cancelled. The main cause of the project's failure was the unreliability of the UR-500K rocket.
Trainer review with S G Darevskiy. It is estimated that the trainers only meet 25% to 30% of the total training needs of the cosmonauts. In the next year Kamanin wants Darevskiy to exert 75% of his effort on the Almaz simulator, 20% on the DOS-7K, and only 5% on the L3. Mishin wants zero effort on Almaz, 70% on DOS-7K, and 30% on the L3.
Two hour meeting between the VVS leadership and Mishin at TsKBEM. Mishin claims he will fly the N1 to orbit this year, and that it will have a payload of 95 to 100 tonnes to low earth orbit. He wants to make 4 to 5 unmanned launches in 1971-1972, followed by one unmanned lunar flyby, culminating in the first Soviet cosmonaut landing on the moon in March 1973. Afterwards the VVS leaders tour the L3 and DOS-7K mock-ups. Mishin asks - Why won't the VVS support his plan for an Indian Ocean landing for the L3? Why is the VVS against a 30-day duration for the first DOS flight? Why isn't the VVS training engineer-cosmonauts as pilots? Kutakhov replies that these are decisions that have to be made by aviation specialists, not by engineers or chief designers. The General Staff supports the VVS position.
It is obvious to Kamanin from the ECS conference that there are many mistakes in the organization of the Soviet space program. There is no single agency directing the program, like the American NASA. There is not only no five year plan for manned spaceflight, there is not even a plan for next year! Decisions on manned space are made erratically by unqualified members of the leadership. There is no single manager of military space projects. Ustinov, Smirnov, Keldysh, and Karas at GUKOS are all pulling in different directions. Ustinov, Smirnov, and Keldysh don't give space more than 10% of their working time.
The Soviet leadership regained some interest in the N1-L3, after the near-tragedy of Apollo 13. It was felt that the Americans might cancel the remainder of the Apollo programme, leaving the road to the moon clear for the Soviet Union. However the successful flight of Apollo 14 redeemed the project, and the Central Committee lost all interest in the N1-L3. Additional Details: here....
An expert commission met to consider the N1-L3. Keldysh made several categorical demands:
The review of launch preparations veers off into a discussion of what the booster was now for. Pilyugin questioned the seriousness of intent of the TsKBEM staff. The digital control system priorities within the bureau were with DOS and Almaz -- why wasn't the N1-L3 the priority? Mishin had never been told that the N1-L3 development was lagging. It had no priority with the leadership. Top priority at TsKBEM was Nadiradze's solid propellant ICBM's, followed by the DOS Salyut station, and now Soyuz-Apollo preparations. Meanwhile it was finally recognised that a single-launch scenario was simply impossible, and two N1 launches would be needed to accomplish the lunar landing. But there was no political will to tell the Politburo the bad news -- that two N1's would be needed to be launched to accomplish the landing. The final conclusion was that the bureau needed a new direction, a project with national priority, like the DOS station. Strategic rocket work could be ruled out, as there were already too many players in that field. Additional Details: here....
Superbooster failure of N1 serial number 6L. This was a substantially improved vehicle, incorporating filters in the propellant lines to prevent any foreign objects from getting into the pumps. The shape of the tail of the booster was modified, and ventilation and refrigeration systems were added to keep the engine compartment cool. It was painted white overall to reduce temperatures while sitting on the pad. After liftoff and ascent, an axial rotation was introduced by gas dynamics interactions of the thirty engines with the air slipstream. The launch vehicle developed a roll beyond the capability of the control system to compensate. and began to break up as it went through Max Q. Control was lost at 50.2 seconds into the flight and it was destroyed by range safety a second later. The engines functioned well and did not shut down up to the point of vehicle destruction. No functional payload was carried. It has been stated that this launch did not have a working launch escape system. Additional Details: here....
Further meetings with Mishin's section leaders on 15 and 23 July leading up to a meeting of the N1-L3 Expert Commission with SA Afanasiev on 25 July where the N1-L3 is finally killed.. It is agreed that it could never have landed a cosmonaut on the moon:
1. Agree that the N1-L3 could not land a cosmonaut.
2. LOK, LK - cancelled.
3. N-1 to be used for MKBS, Mars 75, 77, etc.
4. Lunar Expedition - proceed. (but the solution is not clear. Machines may be better.)
5. Costs for N1-L3 to 1 January 1971: 2.9 billion rubles. Required to complete - 3.0 billion.
6. Unreliability must be solved through reliability testing.
7. Extend the use of N1 (LKI, Mars-75, Mars-77, MKBS).
8. What you need to alter under based on this testing.
9. Proceed with development of hydrogen stages, but you need to use the existing stages for now. (Mishin Diaries 2-336) l
TsKBEM was given a completely new structure as a result of the findings of the expert commissions on the disasters for the previous year, Mishin remained as the Chief Designer for the organisation, but each programme now had its own chief designer:
The State Commission was held to verify readiness of N1 7L for launch. Mishin was 'sick' the whole week of the hearings and had to be represented by his deputies. However neither Mishin or his first deputy Okhapkin were available - both were in the hospital. The commission nearly ruled that until Mishin was available, no launch could be approved. However the review continued. Additional Details: here....
There were still three defects in the new digital computer systems and controversy as to whether to fly the fuel cells in the LOK. But without the fuel cells, there could be no translunar mission. The only power available would then be the batteries in the Block G, limiting the flight to low earth orbit. But the launch manager continued to insist there was danger in handling liquid hydrogen. This was simply a bureaucratic hold-up - only 600 kg of LH2 would be flying, which did not represent a real safety issue. Finally a waiver was agreed and the it was decided the LOK would fly with fuel cells.
All else seemed ready to go. The estimated engine reliability was 93%. The turbogenerators had achieved 100% reliability in test stands. There were still dissenting voices on the use of LH2 - the final vote was 7 for flying with it, and 2 against.
Unmanned test of manned lunar mission launch vehicle serial number 7L. This article incorporated significant changes to the previous model, including roll 'steering' engines to prevent the loss of control that destroyed 6L. The rocket ascended into the sky, and the engines ran 106.93 seconds, only seven seconds before completion of first stage burnout. Programmed shutdown of some engines to prevent overstressing of the structure led to propellant line hammering, rupture of propellant lines, and an explosion of engine number 4. The vehicle disintegrated. Additional Details: here....
Ustinov achieved a leadership consensus to kill the N1 by the beginning of May 1974. He achieved the agreement of the other Ministers on the Military-Industrial Commission, and finally Keldysh. Projects that were ongoing that were linked with the N1 included: the lunar base, MKBS space station, Mars robotic soil return spacecraft and manned expedition, a space radio telescope with a 100 m antenna, and multiple channel communications satellites. All of these died with the cancellation. If 8L had been successful, then after 1 or 2 further test launches, the N1-L3M could begin flying. That meant that the Soviet Union was within 3 to 4 years of establishing long-term lunar expeditions and a moon base. The Americans would have been leapfrogged. Instead, the leadership decided to develop a completely new heavy-lift launch vehicle, which never became operational before the Soviet Union collapsed.
Glushko formally cancelled the N1 within the new NPO Energia on 13 August 1974 with the support of Ustinov, even though he had no decree of the VPK Military-Industrial Commission or the Central Committee authorising such an act. The N1-L3 itself was not officially closed down until the resolution of February 1976 starting work on the Energia/Buran boosters. By that time 6 billion roubles had been spent on the N1 over 17 years. Additional Details: here....
He solicited their support in the reorganization and new projects for the bureau. Glushko was sartorially perfect, and had an aristocratic air, never using the familiar forms of address in Russian. He only loosened up a little in the last years of his life. He was a nitpicker, correcting Russian syntax in documents. He was capable of clear logic but did not have the intuitive genius of Korolev (according to Barmin, while Korolev did not look after his appearance, he possessed a pure 'Russian' intelligence).
